In short
A UX roadmap is not your backlog with nicer fonts or a calendar of unvalidated ideas. It is a capacity-aware order of user problems, evidence, dependencies and learning, and it usually starts when leadership admits the backlog has no believable priority left. Here is how to build one step by step, why large redesigns should ship in coherent pieces, and which mistakes turn a roadmap back into a wish list.
In this article
- What a UX roadmap is — and what it is not
- Where UX roadmaps actually come from
- Why an outside view changes the roadmap
- Is your backlog a sign of opportunity or of chaos?
- If you only need the backlog sorted, you need a project manager
- What goes into a UX roadmap
- How to create a UX roadmap, step by step
- Choosing a roadmap format
- Should a UX roadmap have dates?
- Large redesigns: release in steps, protect the happy path
- Three example UX roadmaps
- Facilitating the roadmap when stakeholders disagree
- Who owns the UX roadmap
- Keep the roadmap alive
- Common UX roadmap mistakes
A UX roadmap is a plan that sequences user and product problems — and the learning needed to solve them — by evidence, outcomes, dependencies and real team capacity. It is not a feature backlog with a UX label, and it is not a calendar of solutions nobody has validated yet. Its job is to stop a team from building priorities that contradict each other, and to show what has to happen first, second and later, and why.
That sounds tidy. The work behind it is not. A UX roadmap usually starts on the day a CEO, founder or CPO admits that demand is far bigger than capacity and the backlog no longer contains any believable order. In our work with product teams, the template is the easy part. The honesty is the hard part.
Every conflicting priority spends the same scarce design and engineering capacity. Sorting the backlog into prettier columns will not resolve the disagreement underneath. ANODA brings user research, cross-industry experience and independent facilitation together, so your team stops arguing over the loudest request and starts delivering the changes that matter.

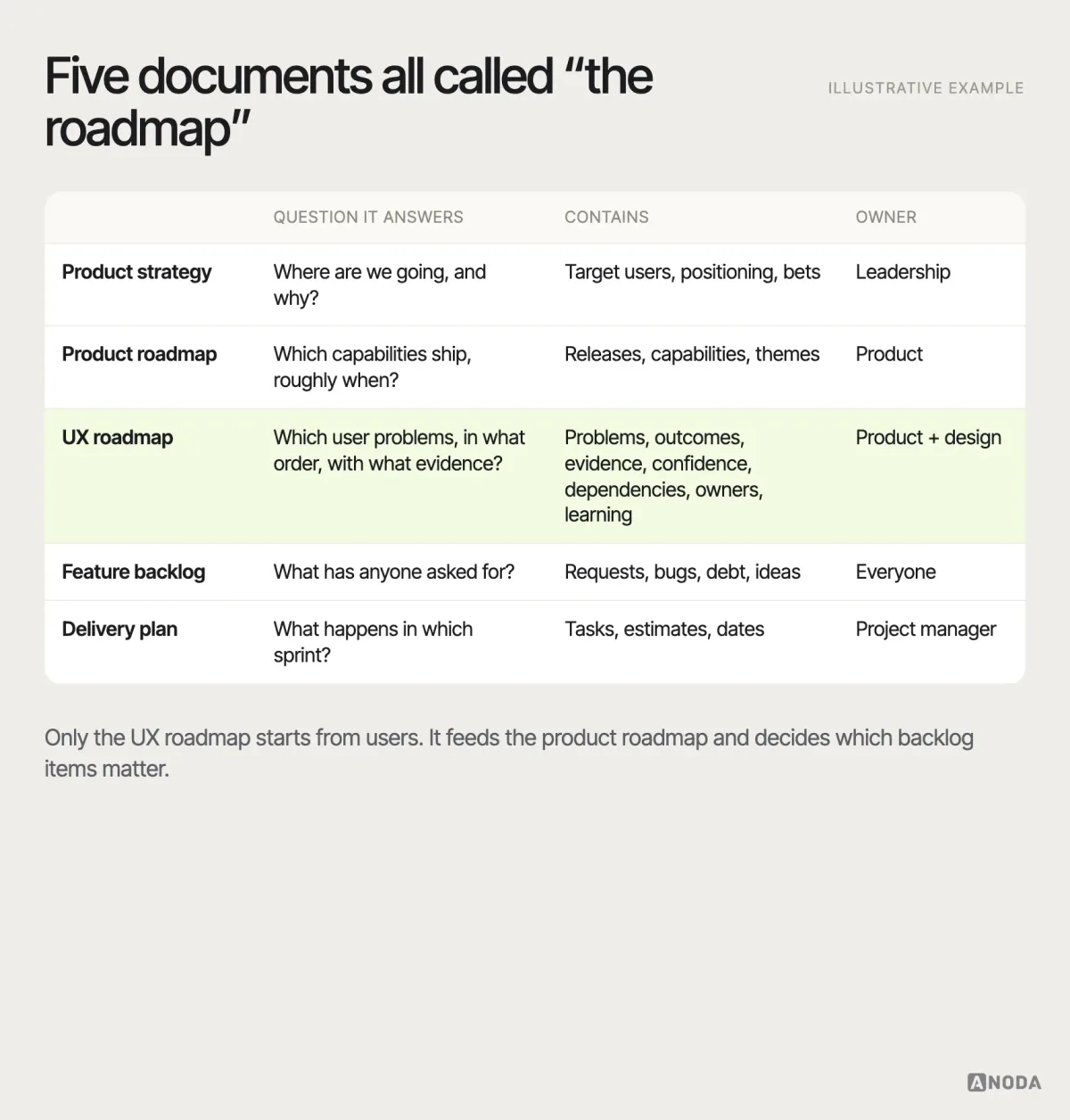

What a UX roadmap is — and what it is not
A UX roadmap connects three things over time: what users struggle with or need (evidence), what the business is trying to change (outcomes) and what the team will do and learn to get there (sequence). Each item on it is a problem or opportunity area with an owner, a level of confidence and a signal that tells you whether it worked.
It is easy to confuse with its neighbours:
- Product strategy decides where the product is going and why. The UX roadmap is one way of executing it, not a replacement for it.
- A product roadmap sequences capabilities and releases across the whole product. A UX roadmap focuses on the user problems, the experience coherence and the learning behind those releases, and often feeds it.
- A feature backlog is an inventory of everything anyone has asked for. The roadmap is the decision about which of those requests matter, in which order, and which to drop.
- A delivery plan schedules work into sprints and dates. The roadmap sets the order and the reasons; the delivery plan fits it into the calendar.
- A research plan schedules studies. On a UX roadmap, research appears as learning milestones tied to the decisions they unlock.
- A UI/UX career roadmap — the list of skills a junior designer should learn — is a different thing entirely, whatever search results suggest.
Where does a “UX strategy roadmap” fit? UX strategy is the longer-term view of the experience the product should offer and the principles behind it — who it serves first, which journeys define it, what it will never compromise. The UX roadmap is that strategy turned into sequence: the next problems to solve, in order, given what the team knows and can deliver right now. A strategy without a roadmap stays a presentation; a roadmap without a strategy turns into whatever the loudest stakeholder wanted this quarter.

Where UX roadmaps actually come from
In practice, almost nobody commissions a UX roadmap on its own. Oksana Kovalchuk, ANODA’s founder, cannot remember a single time it happened outside a UX audit or after an Activation Audit — and she has a theory about why.
The CEO, founder or CPO needs to admit that they are drowning. We are all used to putting on a brave face and saying everything is fine, but this is like a meeting of anonymous CPOs with enormous backlogs. Everyone has to applaud each other and say: yes, we have a huge backlog. And the most important point is that everyone has one. I do not know a single living company whose team is not drowning in its backlog.
Oksana KovalchukFounder & CEO, ANODAThat is why the roadmap usually appears as the second half of a diagnosis. A UX audit or an Activation Audit establishes what is actually wrong and what the evidence says; the roadmap turns that into an order of work the team can deliver. Starting with the roadmap and skipping the diagnosis is choosing the route before you have looked at the map.
SEOSpace shows how that connection reaches the product. ANODA reviewed the live experience finding by finding, each with a recommendation, then carried that work into onboarding, audit tasks ordered by priority and one interface system across the extension, web app and landing pages. Figma handoff, Loom walkthroughs and design QA kept those decisions with the client’s developers. The point of the roadmap is the next useful task the team can deliver, not another sorted list.
Why an outside view changes the roadmap
The people inside a company know the product better than anyone, and they are also the people with the most reasons not to say certain things out loud. The head of sales will not publicly downgrade the feature he promised. The CTO will not volunteer that the team cannot deliver the plan with current staff. The founder will not easily admit that a favourite initiative has no evidence behind it.
An independent partner has no stake in any of those positions, which is exactly what makes it useful. In Oksana’s words, it is less an audit than a kind of help — and it only works once leadership accepts that outside help is needed. What the outside view adds is concrete:
- User evidence, gathered without an internal agenda.
- Cross-industry pattern recognition — having seen how similar products solved, or failed to solve, the same problem.
- Continuous competitor research, so the roadmap reflects where the market is going, not only where the team has been looking.
- A realistic view of delivery, from having sequenced large changes before.
None of this replaces the team’s knowledge. It gives the team permission to act on what it already half-knows.
Is your backlog a sign of opportunity or of chaos?
A huge backlog, on its own, tells you very little. Oksana describes two extremes. A growing pile of feature requests, bugs and technical debt can mean the product is doing well — customers want more, the market is pulling. Or it can mean the opposite: a heap of disconnected requests, and a sales manager nobody validates who promises everything to everyone.
The roadmap exercise has to tell those apart. The questions are blunt:
- How many backlog items trace back to user evidence, and how many to one loud customer, one internal opinion or one sales call?
- How many are promises already made to clients, with dates attached?
- Which bugs block real tasks, and which are cosmetic?
- Which technical debt is slowing every release, and which is merely ugly?
A backlog full of validated opportunities needs sequencing. A backlog full of unvalidated promises needs someone to say “no” — and that is much easier for an outsider with no internal stake than for the product manager who has to sit next to the sales team tomorrow.
If you only need the backlog sorted, you need a project manager
It is worth being honest about this, because it saves money. Reorganising a backlog is not technically complicated. Oksana compares it to baking from a reliable recipe: there is a method, you follow it, and you get a repeatable result. Write everything down, group it, estimate it, fit it to the calendar.
Her other analogy sets out who does what. A product manager decides which clubs and classes a child goes to; a project manager makes sure the child arrives at each one on time and in one piece. If your problem is getting the child to the right place on time — sorting, estimating, scheduling — hire a good project manager. They will do the card sorting and the scheduling, and they will do it well.
You need a UX roadmap when the questions are different: which user problems deserve scarce capacity, which features have to ship before others for the product to make sense, what the team must learn before it commits, and how to change a large product without breaking it for the people who already depend on it.

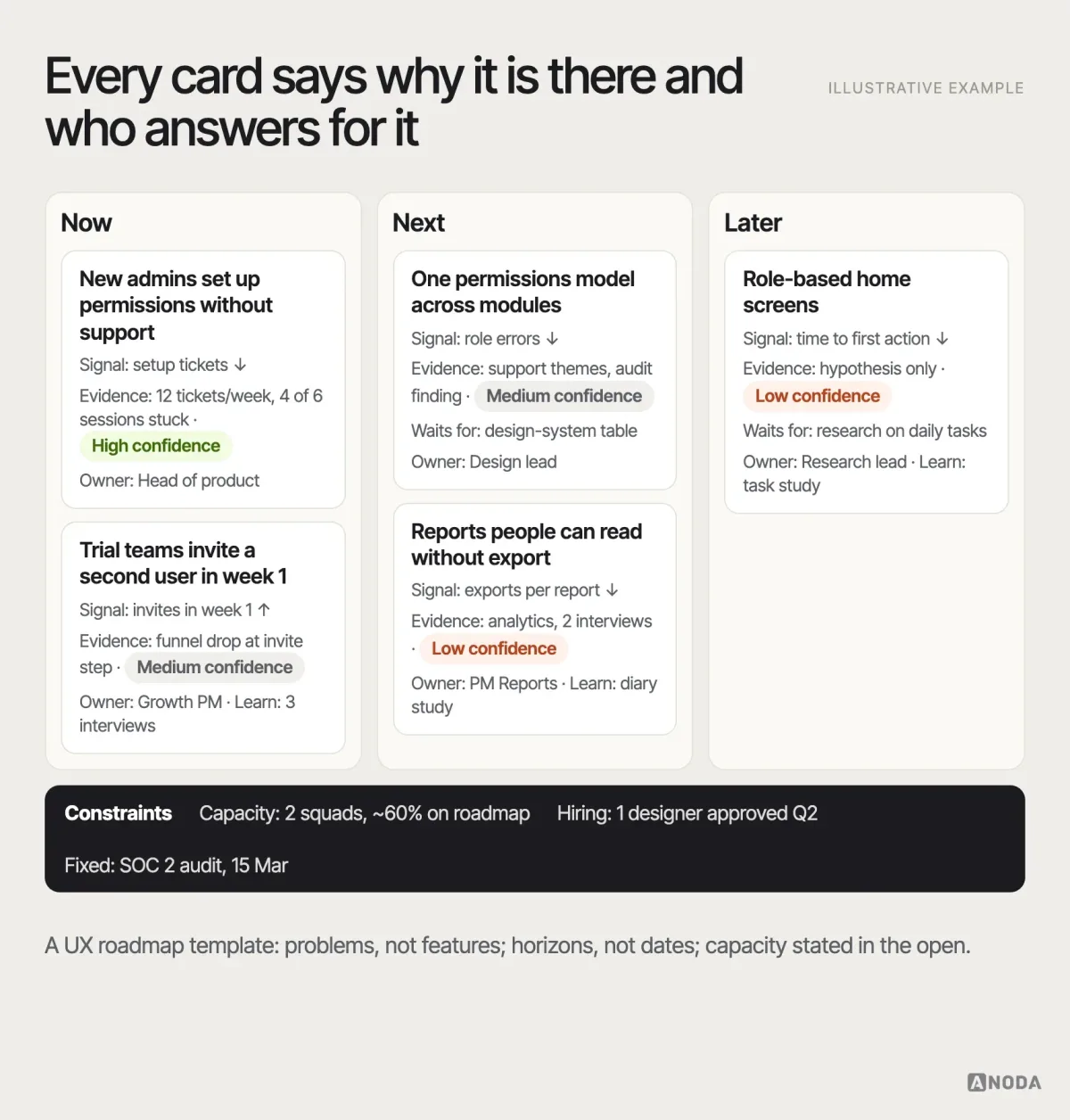

What goes into a UX roadmap
A roadmap that helps a team decide contains, for each item:
- The problem or opportunity area, described as a user problem, not a feature: “new team admins cannot tell which permissions to give accountants”, not “permissions redesign”.
- The outcome it should change, and the signal that shows it did.
- The evidence behind it, and how strong that evidence is.
- Assumptions and confidence — what you believe but have not verified, and what would change your mind.
- Dependencies — what has to happen first, in design, engineering, data, legal or content.
- An owner who is accountable for the outcome, not just the task.
- A horizon — now, next or later — rather than a false-precision date.
- Learning milestones — the research or test that will unlock the next decision.
Around the items, the roadmap also needs its constraints stated in the open: team capacity, hiring plans, fixed management deadlines and commitments already made to customers. A roadmap that ignores capacity is a wish list with a nicer layout.

How to create a UX roadmap, step by step
This is the sequence we follow. It is deliberately more about decisions than about documents.
1. Frame the decision
Write down what the roadmap must help decide, over what period and for whom. “Which three user problems get most of our capacity next quarter” is a decision. “Plan UX for 2027” is a mood.

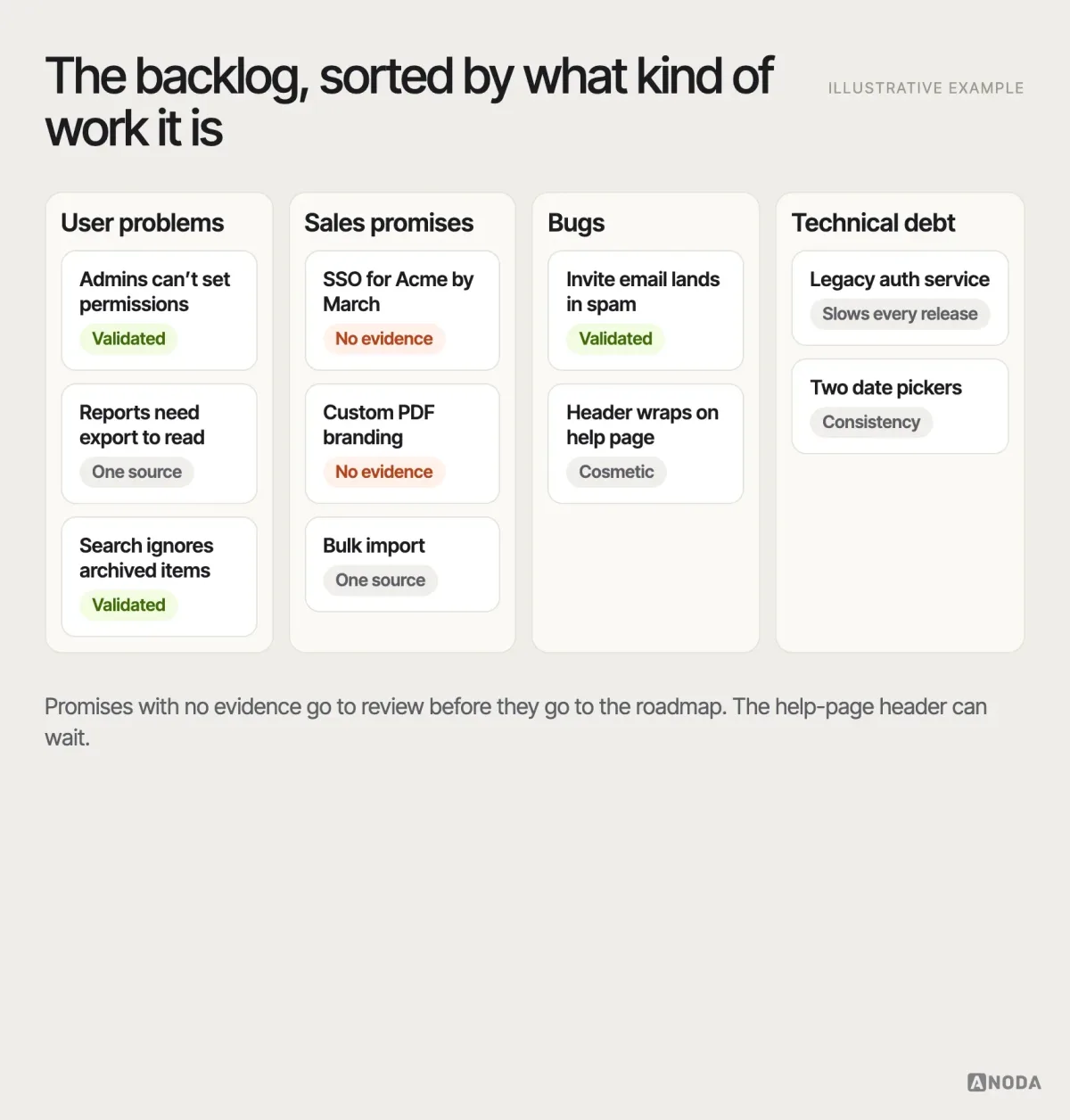

2. Inventory everything
Every backlog item, feature request, sales promise, known bug, piece of technical debt, experiment and half-finished initiative goes onto one list. No filtering yet. Teams are usually surprised by how much is in flight that nobody is tracking.
3. Separate the types of work
Sort the inventory into user problems, sales and client commitments, defects and technical debt. Mark what has evidence behind it and what does not. This is where the backlog starts to show whether it is opportunity or chaos.

4. Put capacity, hiring plans and deadlines on the table
This is the uncomfortable step. Oksana calls the whole roadmap process a kind of psychological and technical striptease: leadership has to show how much the team can really deliver, which hires are actually approved, which deadlines have already come down from management and which commitments were already made to clients. None of it is flattering, and all of it is necessary. A roadmap built on imaginary capacity is fiction the team will be blamed for.
5. Bring in user and market evidence
Talk to users, review research, analytics and support evidence, and look outwards. An independent partner adds something the team rarely has time for: continuous competitor research and pattern recognition across the industries it works in. If an outsider can see a product gap in your market, your competitors can see it too — that information is not secret. It also produces honest feedback on direction. If the backlog is full of polishing a misaligned heading on the third page of the help centre while the roadmap has nothing for a capability your market now treats as basic, somebody should say so plainly. Competitor research for a roadmap does not mean copying anyone’s feature list. It means understanding which problems your competitors are solving for the same users, which expectations that creates, and where nobody is serving users well yet. Look at their onboarding, their pricing pages, their release notes, their public reviews and what their customers complain about. The goal is to know which of your backlog items are table stakes, which are differentiators and which are catching up to something the market has already moved past.
When the evidence itself is thin or contradictory, commissioning UX research before committing is cheaper than building the wrong thing well.
6. Surface assumptions and rate confidence
For each candidate item, write what you are assuming and how confident you are. High-impact items with low confidence become learning milestones, not delivery commitments: test first, then decide.

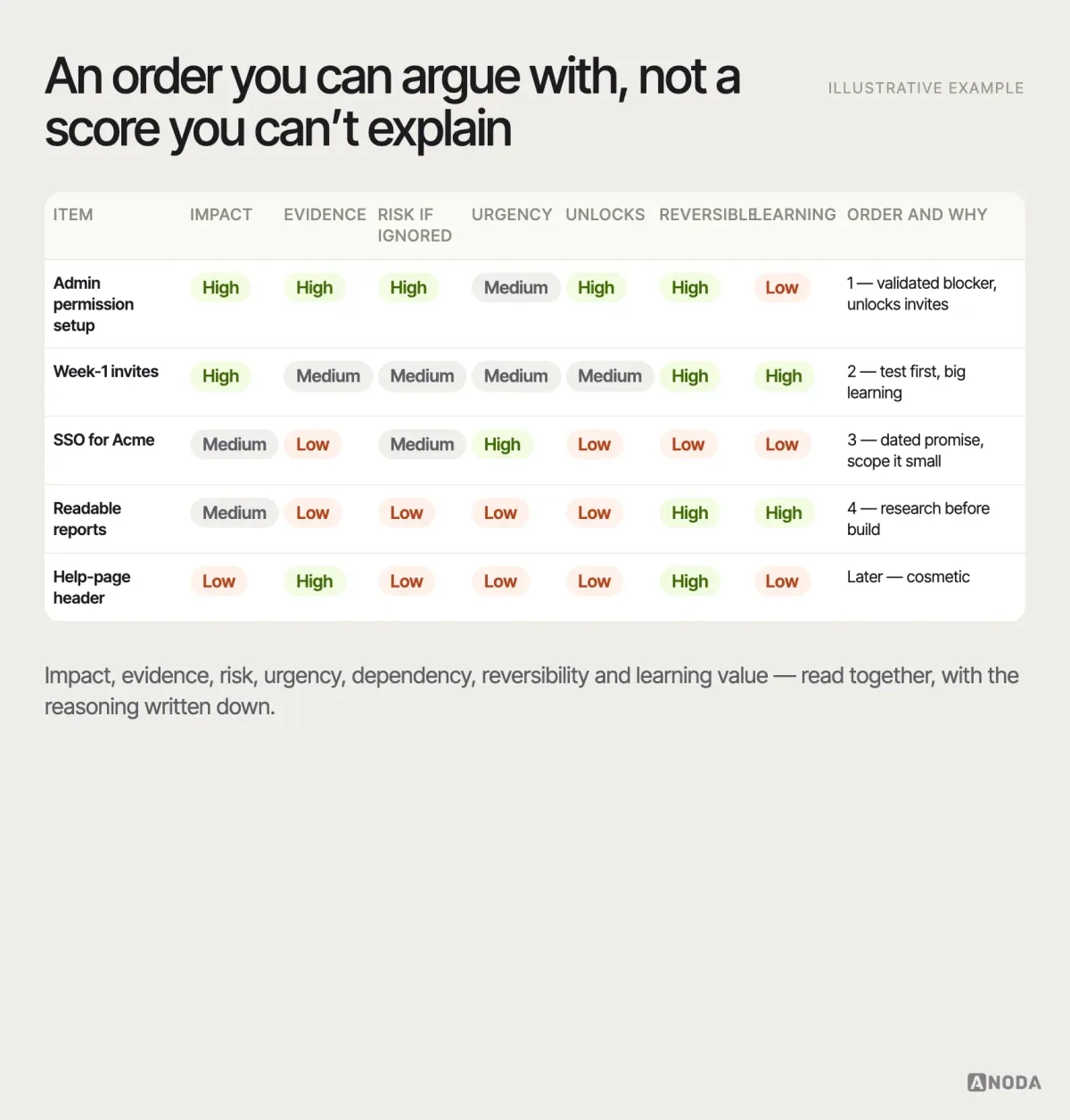

7. Prioritise without fake precision
Scoring formulas that produce a number to two decimal places look scientific and hide the judgement inside the weights. Use a small set of criteria instead and discuss them openly:
- Impact on the user outcome and the business outcome.
- Evidence strength — validated, likely or a hunch.
- Risk of doing it, and of not doing it.
- Urgency — deadlines, commitments, market timing.
- Dependency — what it unlocks or waits for.
- Reversibility — how costly it is to undo if you are wrong.
- Learning value — how much it teaches you about the next decision.

8. Map dependencies and coherence risks
Some features only make sense after others; some changes will make the product inconsistent if they ship alone. Draw those links explicitly. This is the core of UX sequencing: deciding which features follow which others so the product does not lose its coherence along the way.
9. Choose horizons, assign owners
Place each item in now, next or later. Give each an accountable owner. Items with no owner are wishes; move them to “later” or delete them.
10. Communicate uncertainty and set review triggers
Say clearly what is committed, what is planned and what is exploratory. Then agree what would change the roadmap: a research result, a missed metric, a new competitor move, a change in capacity. Those triggers turn the roadmap from a slide into a working tool.
Evidence for the roadmap
Arguing about priorities because nobody has the data?
We run the research that settles which user problems deserve your capacity — before the roadmap commits to them.
Choosing a roadmap format
The same content can be laid out in different ways, and the format should follow the audience:
- Now / Next / Later is the default for product teams. It shows order and commitment without false dates and makes it easy to move items as evidence changes.
- Themes or outcome lanes — “activation”, “trust and permissions”, “reporting” — work well for leadership, because they show where capacity goes and why.
- A timeline with fixed points suits large modernisations and regulated products where some dates genuinely are fixed. Keep the fixed points fixed and the rest in ranges.
- A research roadmap view filters the same items to show learning milestones only, for the research team and whoever funds it.
Whatever the format, keep one source of truth. Three versions of the roadmap in three tools is how teams end up with three different plans.
Should a UX roadmap have dates?
Mostly, no — at least not for anything you have not validated. Horizons (now, next, later) communicate order and intent without promising certainty the team does not have. Dates belong on the delivery plan, once an item is understood well enough to estimate.
The exception is constraints that already have dates: a regulatory deadline, a contractual commitment, a launch the business has announced. Those go on the roadmap as fixed points, and the rest is sequenced around them. What you should avoid is a roadmap where every unvalidated idea carries a delivery month; it guarantees disappointment and teaches stakeholders to stop believing the plan.

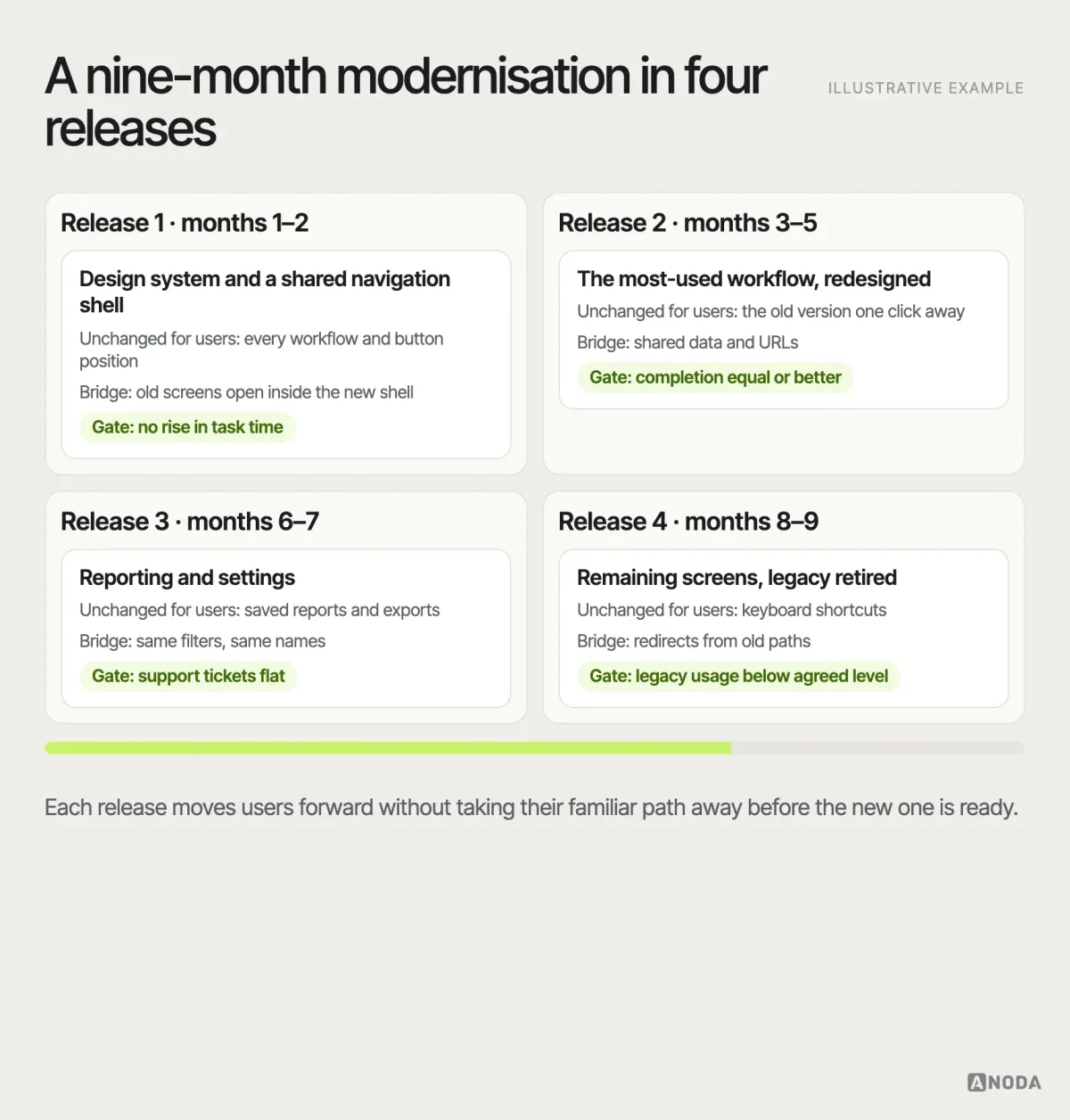

Large redesigns: release in steps, protect the happy path
This is where UX roadmaps have become most valuable recently, particularly as AI speeds up how much can be designed and built. Old, complex interfaces cannot responsibly be replaced in one release — and Oksana’s advice is that trying to is almost always a bad idea.
Your users have already got used to your old, even terrible interface. They have muscle memory for where the buttons are; they no longer look at them. They accepted years ago that it is ugly and inconvenient, made peace with their fate, and now they just want to finish their task. Nobody wakes up thinking: I’ll spend ten hours in Google Sheets today. They want to complete their happy path and close your product.
Oksana KovalchukFounder & CEO, ANODAA big-bang redesign forces everyone to relearn the product at once, in the middle of doing their actual job. It is repainting every sign in a train station overnight: the new signs may be better, and on Monday morning nobody can find their platform.

The roadmap’s job in a large modernisation is to split it into coherent releases. For a big, slow-moving product — the cybersecurity and government platforms we redesign are good examples — the UI work might span something like nine months, with development teams busy with their own problems, dependencies creating waiting time and delivery sometimes still bound to waterfall processes. The questions the roadmap answers are practical:
- What ships first, and what must ship with it so the first release makes sense on its own?
- How do old and new parts stay connected, so the application does not look like two unrelated products?
- Which familiar paths must keep working, unchanged, throughout the transition?
- Where do you start — with the most-used flow, the most painful one, or the one with the fewest dependencies?

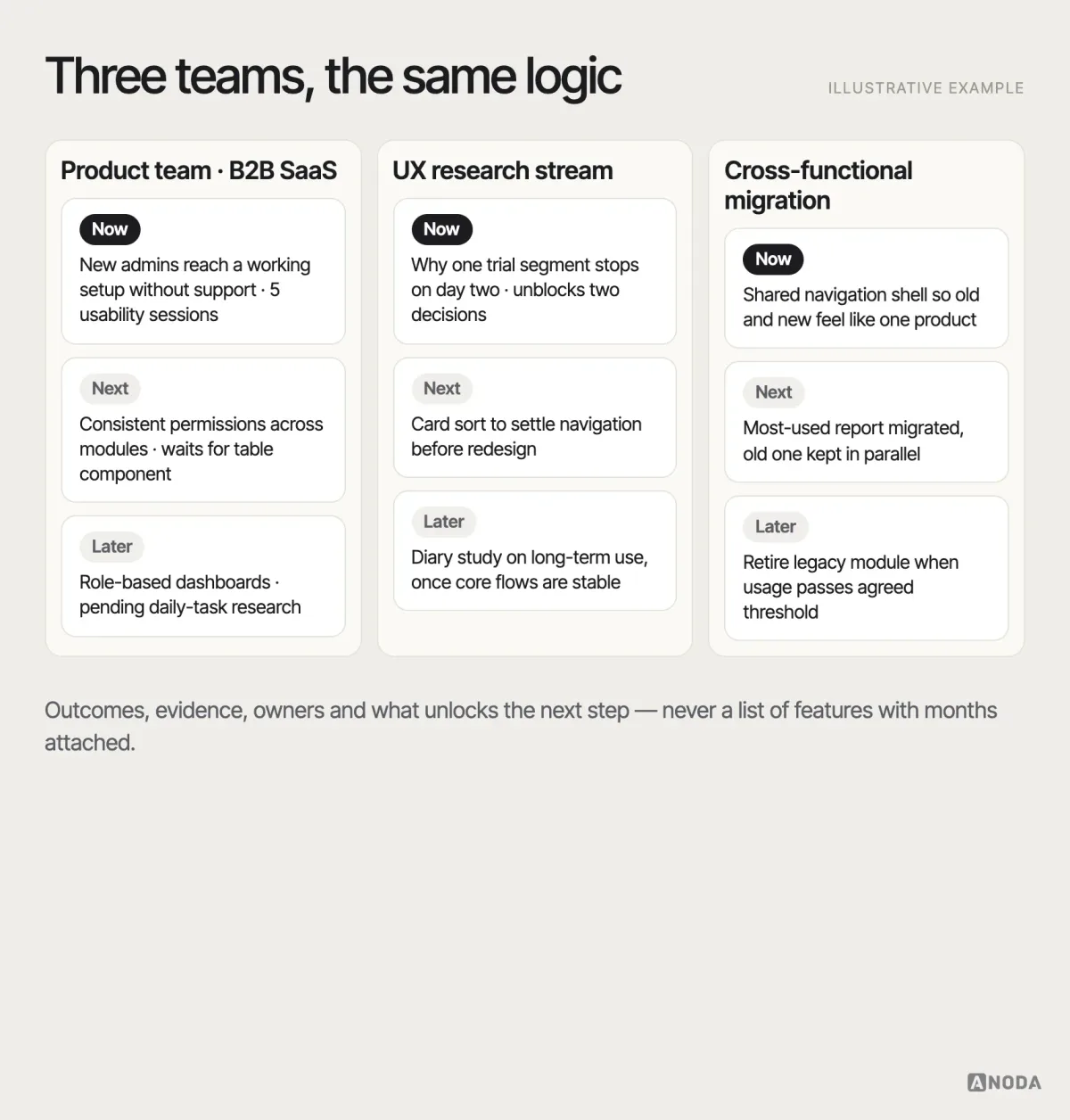

Three example UX roadmaps
Templates are useful only when you can see what goes in them. These examples are illustrative, not client histories.
A product team. A B2B SaaS team with a two-year backlog and flat activation. Now: new admins reach a working setup without support (evidence: onboarding funnel and ticket themes; owner: product lead; learning milestone: five usability sessions on the setup flow). Next: consistent permissions across modules, which depends on the design-system table component. Later: role-based dashboards, pending research on what each role needs daily.
A UX research stream. A research team supporting three product squads. Now: understand why trial users in one segment stop after day two, because it blocks two roadmap decisions. Next: a card sort to settle navigation before the redesign starts. Later: a diary study on long-term use, once the core flows are stable.
A cross-functional initiative. A company moving an old reporting module into a new platform. Now: a shared navigation shell so old and new areas feel like one product. Next: migrate the most-used report and keep the old one available in parallel. Later: retire the legacy module once usage of the new report passes an agreed threshold.

If the team is still unsure which working framework to use around the roadmap — dual-track discovery, design sprints, lean UX — our overview of UX design frameworks compares the common options. And when the problem space itself is not yet validated, product discovery comes before any roadmap.
Facilitating the roadmap when stakeholders disagree
Disagreement is not a sign the roadmap is failing; it is the roadmap doing its job. Sales wants the promised feature, engineering wants to pay down debt, marketing wants the launch, and each is right about something.
What helps:
- Agree the criteria before the items. Once everyone accepts how priority is decided, arguing about individual items becomes much shorter.
- Put evidence on the wall. A session clip or a support ticket in a customer’s own words ends more debates than any opinion.
- Make trade-offs explicit. “If this moves to Now, that moves to Next” is a decision people can own; “we’ll do both” is a decision the calendar will make for you.
- Use an outsider when politics are heavy. An independent facilitator with no stake can say what everyone inside is thinking and nobody can afford to say.
That facilitation — turning competing inputs into a shared order of work — is what our UX consulting engagements focus on.
Who owns the UX roadmap
Ownership is usually shared and should be written down. Product leadership owns the priorities and the trade-offs; design and research own the user evidence and the coherence of the experience; engineering owns feasibility, dependencies and estimates; the project manager owns fitting the result into the delivery calendar. One person — often the head of product or design — should own the document itself: keeping it current, running the reviews and saying no to items that arrive without evidence. When everybody owns the roadmap, in practice nobody updates it.
Keep the roadmap alive
A roadmap that is presented once and then lives in a slide deck is decoration. Keep it current:
- Version it and keep a short changelog: what moved, and why.
- Review it regularly — for example, monthly at the item level and quarterly for the overall direction, adjusted to the team’s pace — and whenever a review trigger fires.
- Tie it to delivery. Each item on “Now” should be visible in the sprint plan; if it is not, the roadmap and reality have separated.
- Close the loop. When an item ships, check its outcome signal, and let the result change what comes next.
Some events should reopen the roadmap immediately, regardless of the review calendar: a research finding that contradicts a top priority, a metric moving the wrong way after a release, a significant competitor launch, a change in funding or headcount, a new regulatory requirement, or a large customer whose needs reshape the segment you serve. Name these triggers in advance so that changing the plan is a planned response, not a panic.
Common UX roadmap mistakes
- A feature list with a UX label. “Redesign dashboard, add dark mode, new onboarding” is a backlog, not a roadmap.
- Unvalidated sales promises treated as priorities because someone already told a client.
- Dates presented as certainty for work nobody understands yet.
- No capacity model, so everything is planned and nothing is delivered.
- No link to research, so priority is decided by seniority.
- No owners, so nothing is anyone’s fault — or achievement.
- Everything marked high priority, which means nothing is.
- Big-bang redesigns that ignore muscle memory and delivery capacity.
- A static slide disconnected from what the team actually builds.
A UX roadmap is not a promise to deliver every backlog item. It is a capacity-aware sequence of user problems, evidence, dependencies and learning decisions. Use research and market context to decide what matters, split large redesigns into coherent releases, and protect people’s ability to finish their familiar task while the product changes around them. The goal is not a roadmap that looks organised. It is a team that stops building priorities that cancel each other out.

UX roadmap
Too many priorities, not enough people?
We bring the user evidence, the market view and an outside voice, and help you turn a drowning backlog into an order of work your team can actually deliver.
Frequently asked questions
What is a UX roadmap?
A UX roadmap is a plan that sequences user and product problems, and the research needed to solve them, by evidence, outcomes, dependencies and team capacity. Each item describes a user problem or opportunity with an owner, a confidence level and a signal of success. It guides decisions about what to work on first rather than listing features with dates.
How is a UX roadmap different from a product roadmap or backlog?
A backlog is an inventory of everything anyone has asked for. A product roadmap sequences capabilities and releases across the whole product. A UX roadmap focuses on which user problems deserve capacity, in what order, with what evidence, and how to keep the experience coherent while the product changes. It often feeds the product roadmap and decides which backlog items matter.
What should a UX roadmap include?
For each item: the user problem or opportunity, the outcome it should change and how you will measure it, the evidence and your confidence, assumptions, dependencies, an owner, a horizon such as now, next or later, and any learning milestone. Around the items, it should state team capacity, hiring plans, fixed deadlines and existing commitments openly.
Should a UX roadmap include dates?
Only for fixed constraints such as regulatory deadlines, contractual commitments or announced launches. Everything else is better expressed as horizons, because dates on unvalidated work suggest a certainty the team does not have. Dates belong on the delivery plan once an item is understood well enough to estimate.
How often should a UX roadmap be reviewed?
A practical starting cadence is to review items monthly and the overall direction quarterly, adjusted to the team’s decisions and delivery pace. It should also be reopened whenever an agreed trigger fires: a research result that contradicts a priority, a metric moving the wrong way after a release, a major competitor move, or a change in capacity or funding.
